SAP S/4HANA transformation, part 1 of 3
SAP S/4HANA transformations: why only 8% finish on time
About 35,000 companies must leave SAP's old ERP system, and most completed migrations miss their plan. I analysed the official numbers in Power BI. The surprise: five of the six biggest barriers have nothing to do with technology.
SAP ECC runs the orders, stock, production and finances of around 35,000 companies worldwide. SAP ends mainstream support for it at the end of 2027 and extended support at the end of 2030.1 A paid option stretches that to 2033, and since October 2026 possibly to 2035, but only for customers who move to SAP’s private cloud by 2030.2 Every ECC customer has to move to S/4HANA, its successor, or leave SAP.
So how is it going? I collected the numbers from SAP, its two big user groups and a 200-company study, and analysed them in Power BI.
The market is moving slowly

The licensed share rose from 34% to 39% in eighteen months.3 Among German-speaking companies still investing in ECC, only 37% plan to finish by 2027.4 And a licence is only a contract, so the share of companies actually live is lower still.
Most completed projects miss the plan

In a Horváth survey of 200 companies, 65% went over budget, 65% report serious quality gaps, and only 8% of completed projects finished on schedule. On average they ran 30% longer than planned.5
The barriers are mostly not technical

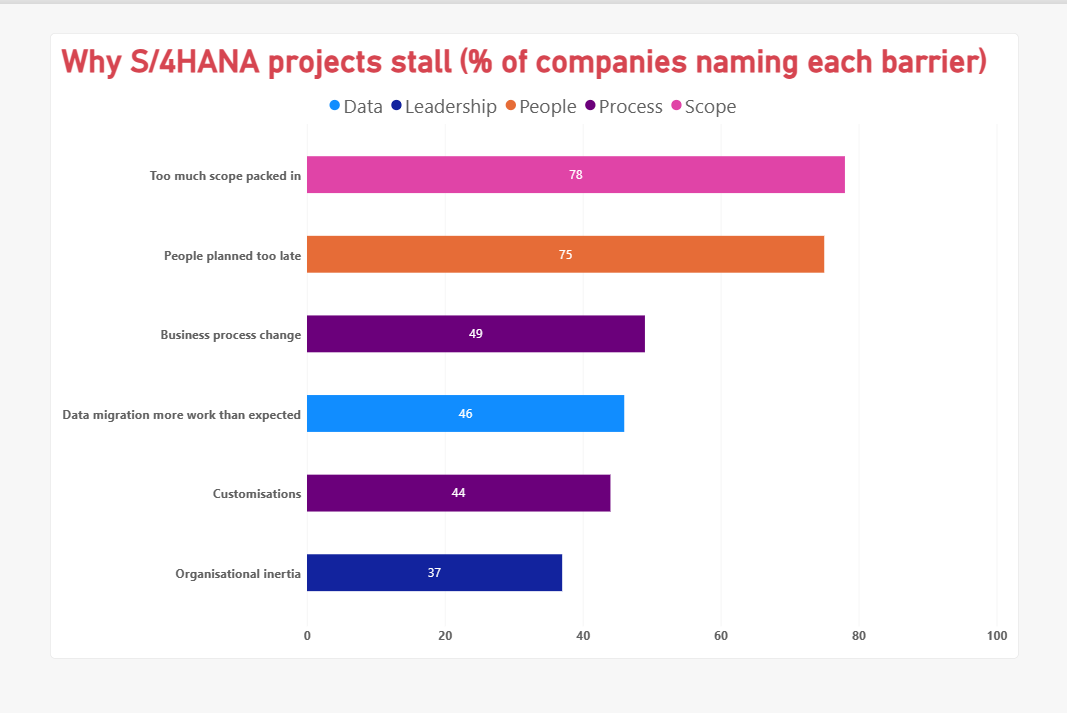

The two most-named problems are packing too much into the project (78%) and planning people too late (75%).5 Next come business process change (49%) and customisations (44%).6 Only data migration (46%) is a technical problem. The rest are decisions about scope, people, process and leadership.

Only one of the six biggest barriers is about technology. The others are decided in the steering committee, long before the system goes live.
Why it hits every department
S/4HANA puts finance and operations on one shared record. That is its biggest benefit, and also its biggest risk.

On the old system, each department kept its own data and finance reconciled the differences at month-end. On S/4HANA there is nothing in between. A wrong price in sales or a late booking in the warehouse shows up in finance the same day. Departments that never had to coordinate now must.
The public failures follow the same pattern. Lidl kept its own inventory valuation method, customised SAP around it and cancelled after seven years.7 Haribo moved 16 plants in 10 countries from old regional systems, and supermarket shipments slipped.8
What comes next
If the problem is organisational, so is the fix. In part 2 I look at the people side: training, psychological safety and what leaders must do. In part 3 I put it together into a consulting approach. The full report, with all visuals and a PDF, is here.
-
